Automating Industrial Panel Finishing Lines: Coordinating Material Handling, Process Stages, and Changeovers

August 31, 2026
Hits:12second

When a panel finishing line fails to meet its production target, the problem is not always the coating machine itself. In many factories, the real losses occur between machines: panels enter the line out of position, sanding cannot keep up with coating, curing capacity limits the conveyor speed, or a color change stops several stations at the same time.

This is why coating line equipment should be planned as one coordinated production system. Feeding, conveying, surface preparation, coating, drying, curing, inspection, stacking, and changeover control must work to the same production rhythm.

For industrial panel manufacturers, the goal is not simply to install an automatic spray painting line or a faster roller coating line. The goal is to produce the required finish repeatedly, at the required output, with controlled material movement and predictable changeover time.

This guide explains how to coordinate an automated panel finishing line from the first panel entering the system to the final approved panel leaving it.

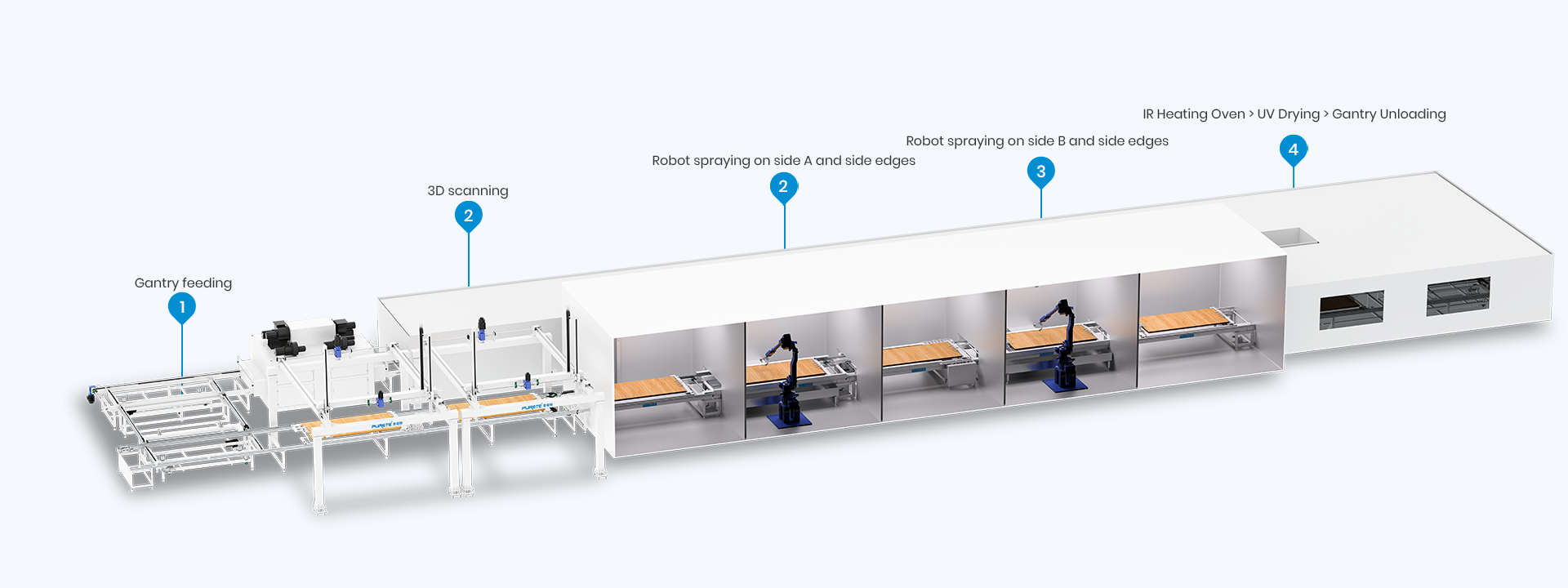

PURETE robotic automatic spraying production line for industrial panels

PURETE Robotic Automatic Spraying Production Line for Industrial Panels

What Does Coating Line Equipment Include?

A complete coating equipment production line normally combines several functional sections:

  • Panel loading and feeding

  • Alignment and positioning

  • Sanding and dust removal

  • Roller, spray, curtain or other coating equipment

  • Leveling, drying or curing

  • Inspection and defect handling

  • Unloading and stacking

  • Conveyors, buffers and transfer units

  • PLC, HMI, sensors and recipe management

  • Ventilation, filtration and safety systems

The exact configuration depends on the substrate, panel geometry, surface effect, coating chemistry, product mix and target capacity.

A flat MDF panel for a high-volume furniture program may require stable loading, sanding, dust removal, roller coating and UV curing. A shaped cabinet door may require 3D scanning, automatic spray programming, a multi-axis spray unit and controlled drying. A high-mix factory may need flexible positioning, recipe control and quick-cleaning systems more than maximum conveyor speed.

The key distinction is simple:

A machine performs one process. A production line coordinates many processes around the movement and quality of the panel.

That distinction should guide both new-line design and automation upgrades.

Start With Material Handling, Not the Coating Machine

Many line-planning projects begin with the coating method. A better approach is to begin with the panel and its movement through the factory.

Before selecting equipment, define:

  • The minimum and maximum panel dimensions

  • Panel thickness and weight

  • Flat, profiled or irregular geometry

  • MDF, plywood, particleboard, HDF, metal sheet or other substrate

  • Required surface effect and coating type

  • Daily and shift output

  • Number of product families

  • Number of colors or coating systems

  • Expected changeover frequency

  • Available factory length, width and height

These details determine how the panel must be loaded, supported, aligned, transferred and inspected.

Panel Staging and Identification

The line should not begin at the first conveyor. It begins in the staging area.

Panels should be grouped by production order, substrate, finish and coating recipe before they reach the loading station. If different products are mixed without clear identification, the automation system may run the wrong recipe even when the equipment itself is functioning correctly.

Useful identification methods include:

  • Product or work-order numbers

  • Barcode or QR-code scanning

  • Batch and coating-lot records

  • Visual labels for panel direction

  • Recipe numbers linked to the production schedule

A simple rule is useful: the system should identify the panel at the point where the decision is made, not several stations earlier from memory or paperwork.

Loading and Alignment

Automatic loading must account for more than panel presence. It must control:

  • Panel spacing

  • Leading-edge position

  • Orientation

  • Side alignment

  • Surface contact

  • Double-sheet prevention

  • Transfer stability

Poor alignment at the entrance can create problems throughout the line. A panel entering a spray zone at an angle may receive uneven coverage. A misaligned panel entering a roller coater may create edge variation or contact the wrong part of the roller. A panel that shifts during transfer may also create an inspection failure even when the coating parameters are correct.

The loading system, conveyor and coating equipment therefore need a shared reference position.

Conveyors and Transfer Points

Conveyors are not passive transport devices. They establish the distance between panels, control process time and determine how one station communicates with another.

A well-designed transfer point should answer four questions:

  1. Where is the panel positioned?

  2. At what speed does it enter?

  3. What confirms that the panel has transferred successfully?

  4. What happens if the next station is not ready?

Depending on the line, transfer equipment may include belt conveyors, roller conveyors, alignment devices, lifting units, turning systems, buffer conveyors or accumulation zones.

For large panels, the conveyor must also prevent sagging, vibration and surface contamination. The support method should be selected according to panel size, weight, coating condition and whether the back side can touch the transport surface.

Buffers and Accumulation Zones

A buffer is useful when two process stages have different short-term operating speeds. It can absorb a brief stop, support inspection, or separate product batches during a planned changeover.

However, a buffer should not be used to hide a permanent bottleneck. If the curing oven is consistently slower than the coating station, adding more accumulation only moves the problem downstream.

The best buffer locations are usually:

  • Before a known bottleneck

  • Before inspection

  • Before a planned changeover point

  • Between process sections with different operating speeds

  • Before unloading and stacking

Each buffer should have a defined maximum quantity. When the buffer reaches that limit, the upstream station should receive a controlled stop signal rather than continuing to produce material that cannot move forward.

Coordinate Process Stages Around One Production Rhythm

Surface Preparation

Surface preparation may include sanding, brushing, dust removal, cleaning or other treatment. Its purpose is not only to improve appearance. It also determines whether the coating can be applied consistently.

For panel finishing, the surface preparation stage should control:

  • Surface flatness

  • Dust level

  • Oil or contamination

  • Edge condition

  • Moisture or temperature where relevant

  • Panel orientation

  • Surface readiness for the selected coating

If sanding and coating operate at different capacities, the factory may experience either an empty coater or an accumulating queue of prepared panels.

Coating Application

The coating stage must be selected according to the panel geometry and finish requirement.

A roller coating line is generally suitable for flat, stable surfaces. Its performance depends on the relationship between:

  • Conveyor speed

  • Coating roller speed

  • Metering or applicator roller speed

  • Roller pressure

  • Coating viscosity

  • Coating temperature

  • Substrate thickness and flatness

If the coating roller and conveyor are not synchronized, visible horizontal marks or uneven transfer may occur.

An automatic spray painting line provides more flexibility for shaped surfaces, edges and complex workpieces. It requires coordination between:

  • Panel recognition

  • Spray trajectory

  • Gun distance

  • Gun angle

  • Pump pressure

  • Nozzle selection

  • Panel speed

  • Exhaust and filtration

A curtain coating system has a different control logic. Pump speed, curtain stability, knife gap and conveyor speed influence the coating layer. It is generally used for specific flat-panel finish requirements and must be evaluated together with the coating material.

Drying, Leveling and Curing

The coating station cannot be separated from the drying or curing section.

For liquid coatings, the line may require leveling time before curing. For UV coatings, lamp power, distance, line speed and coating thickness influence curing performance. For water-based systems, evaporation and drying capacity become especially important.

If a line is designed around the maximum speed of the coater but not the actual curing requirement, the result may be:

  • Incomplete curing

  • Surface defects

  • Poor adhesion

  • Blocking during stacking

  • Rework after inspection

  • Reduced usable output

The curing section should therefore be treated as a capacity-setting process, not merely an accessory after the coating machine.

Inspection and Stacking

Inspection must be connected to production control. A panel that fails inspection should not simply continue to stacking and be discovered later.

The line should define:

  • What defects are detected automatically

  • What requires operator inspection

  • Where rejected panels are diverted

  • How the defect reason is recorded

  • Whether the previous panels need to be quarantined

  • Who can release the line after an adjustment

Stacking also affects quality. Panels that are not sufficiently dry or cured may stick together, receive pressure marks or become contaminated during handling.

How to Calculate Takt Time and Practical Capacity

Line speed should be calculated from the required output and the available production time.

The basic formula is:

Takt time = Net available production time ÷ Required good panels

For example, if a factory has 420 minutes of effective production time and needs 300 good panels per shift:

Takt time = 420 minutes ÷ 300 panels
= 1.4 minutes per panel
= 84 seconds per panel

If the panel pitch is 1.4 meters, the initial conveyor speed would be approximately:

1.4 meters ÷ 84 seconds × 60
= 1.0 meter per minute

This is a planning value, not a final operating setting.

The line must also account for:

  • Loading and unloading time

  • Cleaning

  • Changeovers

  • Inspection

  • Short stoppages

  • Panel rejection

  • Maintenance

  • Product variation

  • Curing or drying constraints

A more realistic model is:

Good output =
Theoretical output × Availability × Yield

Theoretical capacity may look attractive on a machine specification sheet, but good output is what the factory can actually sell.

For reference, PURETE equipment data indicates that standard roller and spray systems can operate at very different speeds depending on the process. Roller coating lines may run in the 10–12 m/min range in standard configurations, while reciprocating spray lines for shaped panels are commonly designed around a lower speed range. These figures should never be treated as universal guarantees. The final speed must be verified against the actual panel, coating material, finish target and curing process.

A PURETE reciprocating spray line example lists a line speed of 3–6 m/min, a capacity of 800 m² per 8-hour shift, a total power of 109 kW, an installation area of approximately 50 × 7 m and staffing of 3–5 people. These figures describe a specific project configuration, not a general benchmark for every panel finishing line.

Choosing the Right Finishing Route

Process routeSuitable applicationsMain coordination issuesChangeover considerations
Roller coating lineFlat MDF, furniture panels, flooring substratesRoller speed, pressure, viscosity, panel flatness and conveyor synchronizationRoller cleaning, coating residue and color changes
Automatic spray painting lineShaped doors, profiled panels and complex surfaces3D recognition, spray trajectory, nozzle, pressure and exhaustGun, pump, hose and spray-booth cleaning
Automatic spray painting system with conveyorContinuous panel production and multi-station sprayingPanel spacing, transport stability and spray-zone timingCleaning must include the conveyor, spray path and material supply
Curtain coatingFlat panels requiring specific high-build or high-gloss finishesPump speed, curtain stability, knife gap and conveyor speedResidual coating, filtration and circulation cleaning
Hybrid finishing lineProducts using different surface routesRecipe control, transfer logic and process compatibilityMore complex scheduling and stronger recipe management

A factory should ask three questions before choosing the route:

  1. Is the panel flat or geometrically complex?

  2. Is the production mix high-volume or high-variety?

  3. Is the finish mainly controlled by coating transfer, spraying, curing or a combination?

The best line is not necessarily the fastest line. It is the line that can maintain the required quality while handling the real product mix.

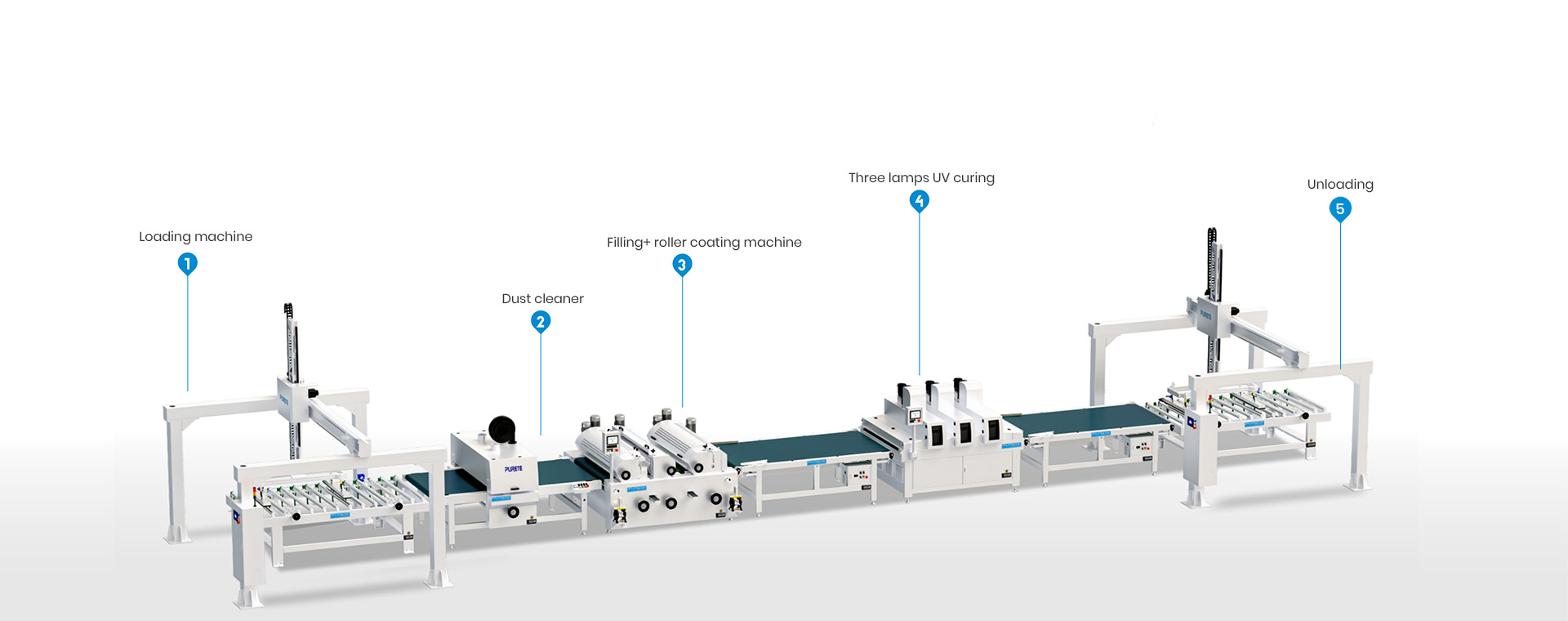

Fully automatic roller coating production line for flat industrial panels

PURETE Fully Automatic Roller Coating Production Line for Flat Panels

Plan Changeovers as a Line-Wide Process

Changeovers are often underestimated because factories measure only the time required to change the coating head. In reality, a changeover affects the entire line.

A changeover may be triggered by:

  • Product size

  • Panel thickness

  • Substrate type

  • Color

  • Gloss level

  • Coating chemistry

  • Spray program

  • Roller arrangement

  • Fixture or support method

  • Curing recipe

A Practical Changeover Sequence

  1. Complete and identify the last approved panel

  2. Stop new panels from entering the line

  3. Remove or isolate unfinished panels

  4. Drain, purge or clean the coating path

  5. Clean rollers, pumps, hoses, spray guns or curtain components as required

  6. Load the new product and coating recipe

  7. Adjust guides, supports, applicators and conveyor settings

  8. Confirm drying or curing parameters

  9. Run a dry cycle or controlled test cycle

  10. Produce the first panel

  11. Inspect and approve the first panel

  12. Release the line for normal production

Separate External and Internal Setup

External preparation may include:

  • Preparing the next coating material

  • Confirming the next recipe

  • Preparing labels and inspection forms

  • Preparing rollers, guns or fixtures

  • Checking substrate and color information

  • Sequencing products into logical families

Internal setup includes:

  • Stopping the line

  • Cleaning and purging

  • Replacing or adjusting components

  • Calling the new recipe

  • Performing dry runs

  • Producing the first panel

This distinction is especially important for small-batch production. A line that can change recipes quickly but still requires long manual cleaning may not deliver a short total changeover.

Measure Changeover Quality

Track more than elapsed time:

  • Planned changeover time

  • Actual changeover time

  • Material consumed during cleaning

  • Number of trial panels

  • First-piece pass rate

  • Rework during the first production batch

  • Time required to return to a previous setup

  • Unplanned downtime after changeover

The best changeover is not the one that ends fastest. It is the one that returns the line to stable, approved production with minimal waste.

First-Piece Validation: The Release Gate

The first panel after a changeover is not just a sample. It is the decision point between setup and production.

The line should not be released until the first piece has been checked against the approved requirements.

What Should Be Recorded?

Record the following information:

  • Product code

  • Panel dimensions and substrate

  • Material or batch number

  • Coating name, color and batch

  • Recipe version

  • Conveyor speed

  • Roller, pump or spray settings

  • Curing temperature, time or UV condition

  • Coating thickness

  • Gloss or color result

  • Adhesion or performance checks where required

  • Appearance photographs

  • Adjustment history

  • Production and quality approval

The purpose of this record is traceability. If a defect appears later, the factory should be able to determine whether the problem began with the material, recipe, equipment setting, cleaning condition or curing process.

Appearance Is Not Always Enough

Visual appearance is important, but it may not be the only acceptance criterion.

Depending on the product, first-piece validation may also include:

  • Coating thickness

  • Gloss consistency

  • Color difference

  • Adhesion

  • Scratch or abrasion resistance

  • Surface hardness

  • Cure condition

  • Edge coverage

  • Smoothness or texture

  • Bond strength for laminated surfaces

The acceptance criteria should be agreed before production begins. Otherwise, operators may make different decisions about the same panel.

Use a Hold Point

First panel → Inspection → Adjustment or approval → Line release → Normal production

If the first panel fails, the line should return to adjustment rather than continue producing panels for later sorting.

For larger production batches, factories should also define routine checks at the beginning, middle and end of the run. This helps identify process drift caused by coating viscosity, roller wear, lamp aging, temperature variation, dust or conveyor instability.

Three Common Factory Scenarios

High-Volume Flat Panels

For high-volume MDF or furniture panels, the main priorities are:

  • Stable loading

  • Accurate alignment

  • Continuous sanding and dust removal

  • Synchronized roller and conveyor speed

  • Reliable curing capacity

  • Low defect rate

  • Minimal unplanned stoppage

In this case, the factory should focus on line balance and repeatability rather than adding unnecessary flexibility.

Complex or Profiled Panels

For shaped cabinet doors, decorative profiles or irregular panels, the priorities change:

  • 3D scanning or shape recognition

  • Automatic program generation

  • Edge and side coverage

  • Stable fixtures

  • Flexible spray trajectories

  • Controlled panel rotation or transfer

  • Reliable inspection

PURETE intelligent spray systems can use 3D vision to recognize different workpiece shapes and automatically generate spraying programs. One equipment configuration supports workpieces up to approximately 2,800 × 1,200 × 100 mm, subject to the final system design and application requirements.

Small-Batch, High-Variety Production

High-variety factories need a different definition of efficiency.

Their main concerns are often:

  • Quick product recognition

  • Recipe accuracy

  • Short cleaning cycles

  • Flexible positioning

  • Easy access to guns, rollers and pumps

  • Low trial-panel waste

  • Fast first-piece approval

For this type of factory, a line that runs slightly slower but changes products reliably may produce more saleable output over the full shift.

Common Mistakes to Avoid

Mistake 1: Selecting Equipment by Maximum Speed

Maximum speed does not represent practical capacity. The slowest process, often curing, inspection or handling, controls the real output.

Mistake 2: Treating the Conveyor as an Accessory

The conveyor determines panel spacing, alignment, transfer timing, process dwell time and accumulation behavior.

Mistake 3: Ignoring the Product Mix

A line designed for one product may perform poorly when asked to process many sizes, colors or coating systems.

Mistake 4: Planning Changeovers Only Around the Coater

Cleaning, recipe control, guides, fixtures, curing and inspection must all be included.

Mistake 5: Releasing Production Without a First-Piece Hold Point

A small setup error can affect an entire batch if the first panel is not formally approved.

Mistake 6: Using Unsupported Performance Claims

Line speed, capacity, coating consumption and labor requirements should always be tied to a specific material, configuration and operating condition.

A Pre-Project Checklist for Buyers

Before requesting a coating line proposal, prepare the following information:

  1. Panel dimensions and thickness range

  2. Panel weight and surface condition

  3. Substrate types

  4. Required coating or finish

  5. Coating chemistry

  6. Target production per shift

  7. Product and color mix

  8. Expected changeover frequency

  9. Available factory space

  10. Required utilities

  11. Existing equipment to be integrated

  12. Inspection and acceptance requirements

  13. Desired future expansion

  14. Photos, drawings or sample panels

The supplier should then provide more than a machine list. A useful proposal should include:

  • Process flow

  • Layout drawing

  • Equipment list

  • Expected operating speed

  • Capacity assumptions

  • Buffer locations

  • Changeover method

  • Cleaning requirements

  • Recipe and control strategy

  • FAT and SAT criteria

  • Training and after-sales plan

Conclusion: Automate the Flow, Not Just the Machines

An automated panel finishing line is successful when the entire process behaves predictably.

Panels must enter in the correct position. Surface preparation must keep pace with coating. Conveyors must maintain the production rhythm. Drying and curing must support the target speed. Inspection must be connected to release decisions. Changeovers must be planned across the full line. Most importantly, the first approved panel must become the reference for the production run.

The right coating line equipment is therefore not simply the machine with the highest speed or the longest equipment list. It is the coordinated system that matches the factory’s panels, finishes, product mix, production target and operating capability.

FAQs

What is coating line equipment?

Coating line equipment is the connected group of machines used to load, transport, prepare, coat, dry, cure, inspect and stack panels in one controlled production flow.

What equipment is included in a complete panel finishing line?

A complete line may include loading equipment, conveyors, alignment units, sanding and cleaning machines, roller or spray coaters, drying or curing systems, inspection equipment, stacking units and PLC-based controls.

How do I calculate the required line speed?

Start with the required good output and the net available production time. Calculate takt time, then compare the required panel pitch and conveyor speed with coating, drying, curing and inspection capacity.

Is a faster conveyor always better?

No. A higher conveyor speed may reduce coating coverage, leveling time, curing performance or inspection stability. The correct speed is the highest speed that still produces acceptable, repeatable quality.

Should I choose roller coating or automatic spray painting?

Roller coating is generally suited to flat, stable panels. Automatic spray painting is more flexible for shaped, profiled or complex surfaces. The final decision should consider panel geometry, finish target, production mix and cleaning requirements.

How can I reduce changeover time?

Prepare the next material and recipe before stopping the line, standardize cleaning, use saved setup parameters, group similar products and make first-piece approval part of the planned changeover sequence.

What should be checked on the first panel?

Check the panel identity, coating material, recipe, appearance, thickness, gloss, color, adhesion, curing condition, edge coverage and any customer-specific performance requirement.

Can one line process different panel materials?

It may be possible, but the different substrates must be evaluated for flatness, absorption, surface energy, coating compatibility, drying behavior and finish tolerance. Testing with the real materials is strongly recommended.

What information should I provide to a coating line supplier?

Provide panel dimensions, substrate, finish target, coating type, production target, product mix, changeover frequency, factory constraints, utilities and existing equipment. Sample panels and drawings make the proposal more accurate.

If you are planning a new line or upgrading an existing one, send PURETE your panel dimensions, substrate information, finish requirements and target output. Our engineering team can help evaluate the material flow, process route, line balance, changeover method and first-piece validation requirements before the final configuration is confirmed.

Request an Automated Panel Finishing Line Review


Contact Us

fill in our contact form.

We will get in touch with you as soon as possible.

Leave a message
